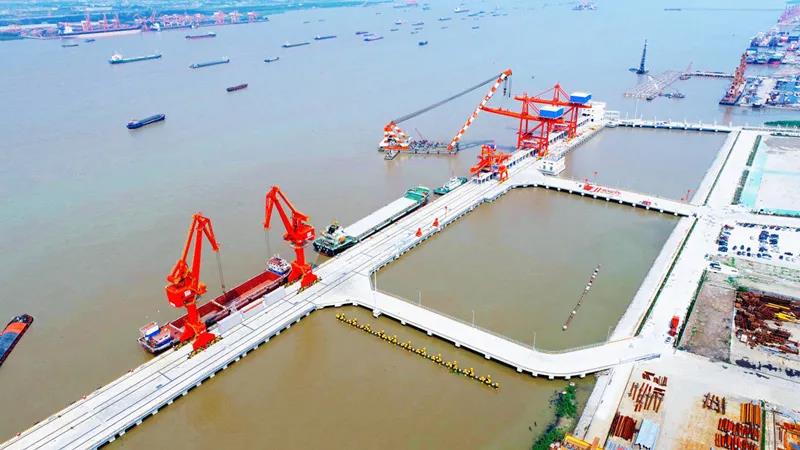

6月30日,杭州華新機電工程有(you)限公司(si)為(wei)中鐵建(jian)港航局泰興港務有(you)限公司(si)建(jian)造的2臺1500t/h卸船機在港區1號泊位順(shun)利完成第(di)二臺前大梁吊(diao)裝(zhuang),標志著為(wei)期8天(tian)的大件吊(diao)裝(zhuang)圓滿結(jie)束(shu),階(jie)段收尾后將(jiang)進入設備調(diao)試(shi)階(jie)段。本次吊(diao)裝(zhuang)滿足了業(ye)(ye)主(zhu)“首船靠泊試(shi)機儀式”的時(shi)間節(jie)點要求,得(de)到業(ye)(ye)主(zhu)高度贊揚(yang)。
該(gai)項目(mu)于2019年(nian)10月簽訂(ding)合(he)同,于2019年(nian)12月開工(gong)(gong)(gong)(gong)生產制(zhi)造(zao),原(yuan)計(ji)劃于2020年(nian)7月交機(ji),但由于期(qi)間(jian)疫情的(de)影(ying)(ying)響,給(gei)生產制(zhi)造(zao)及(ji)整個項目(mu)的(de)外(wai)協(xie)廠家都帶來(lai)很多難題(ti)。在此期(qi)間(jian),公司積極與用戶進行溝通協(xie)調(diao),督(du)促外(wai)協(xie)廠家合(he)理安(an)排工(gong)(gong)(gong)(gong)序,以彌補因疫情影(ying)(ying)響的(de)工(gong)(gong)(gong)(gong)期(qi);同時,華新機(ji)電無錫制(zhi)造(zao)基(ji)地及(ji)時調(diao)整了(le)工(gong)(gong)(gong)(gong)作計(ji)劃,加(jia)(jia)班(ban)加(jia)(jia)點(dian)趕(gan)制(zhi)本項目(mu)的(de)結構(gou)件;現場(chang)安(an)裝隊(dui)更是與時間(jian)賽跑,為了(le)保(bao)證工(gong)(gong)(gong)(gong)程節點(dian),在確保(bao)安(an)全的(de)前提(ti)(ti)下(xia),提(ti)(ti)出“大(da)雨小(xiao)干(gan),小(xiao)雨大(da)干(gan),天(tian)好加(jia)(jia)勁干(gan)”的(de)口號(hao),白天(tian)埋頭苦干(gan),晚上(shang)加(jia)(jia)班(ban)施工(gong)(gong)(gong)(gong),“5+2”,“白加(jia)(jia)黑”是他們的(de)工(gong)(gong)(gong)(gong)作常態。
項目(mu)施工(gong)現(xian)場從6月份(fen)進入全面(mian)搶工(gong)階段,一線技術人(ren)員(yuan)(yuan)蹲守施工(gong)現(xian)場,科學(xue)合理調度施工(gong)人(ren)員(yuan)(yuan)。叉車(che)、吊車(che)、磨光機等機械(xie)聲不絕于耳,管(guan)理人(ren)員(yuan)(yuan)對講機聲波陣陣,一曲節(jie)奏緊張明快的搶工(gong)“交響(xiang)樂”渾(hun)然天成。奮(fen)戰在一線的他們是 “最美(mei)舞者”,為我(wo)們演繹(yi)了(le)爭分奪秒的“搶工(gong)大(da)戰”。
中(zhong)鐵建港航局(ju)泰(tai)興港務七圩作(zuo)業(ye)區(qu)公(gong)用(yong)碼頭工程(cheng)位于江(jiang)蘇省泰(tai)興市,由(you)中(zhong)國(guo)鐵建港航局(ju)與泰(tai)興虹橋工業(ye)園區(qu)合作(zuo)共建,總(zong)投(tou)資13.9億(yi)元,是國(guo)家財(cai)政部和(he)江(jiang)蘇省PPP示范項目,也是中(zhong)國(guo)鐵建首(shou)個(ge)集“投(tou)資、設計、建設、擁(yong)有、運營、維護”于一體的專業(ye)化社會公(gong)共碼頭。
友情鏈接
